Building a Phinisi: The Commissioning Process
Yard selection, contracts, timber and supervision, from keel ritual to launch.
Hull to launch is the short part. A realistic map of a phinisi commission — timber to sea trials — with honest slippage ranges and every duration flagged as an estimate.
Industry-reported durations put a 20 m hull at 8–12 months, 30 m at 12–18 and 40 m-plus at 18–24 months — sometimes three years (estimate). Those cover hull and basic superstructure only. Fit-out, systems and certification add months more.
Reported duration and slippage risk for each phase, from timber to sea trials. All durations are estimates; no official data exists.
The 6-to-18-month overrun pattern is structural, not bad luck. Six delay drivers recur — and each has a mitigation that works when it is written into the contract.
Ulin procurement is unpredictable, and monsoon rain slows planking and closes tow windows. Insist on verified, seasoned ulin inventory before signing — not a promise to source it.
Most stalls are disputes over what the quote included — Dunia Baru's hull quote left out USD 100,000 of fastenings. Use milestone-based fixed-price contracts; scope creep is the most controllable driver.

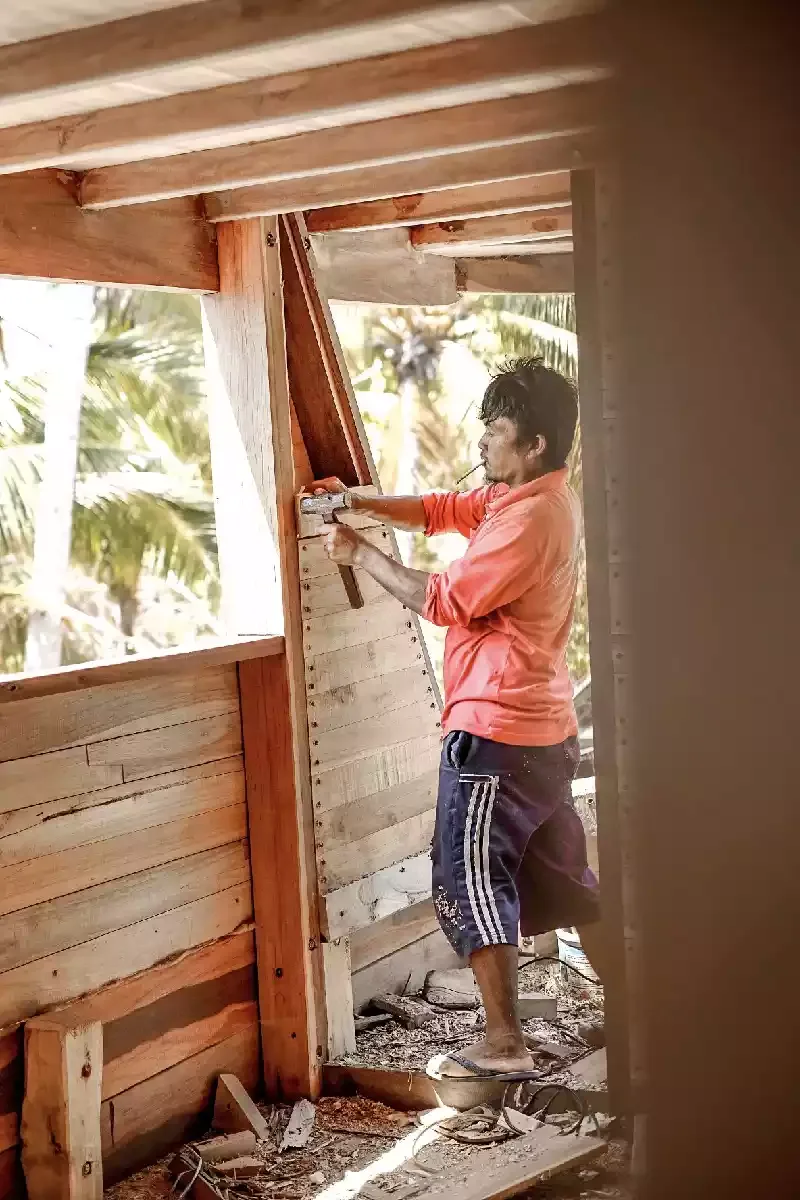

Fit-out venue changes force re-transit and rework; running out of money pauses everything. Keep a supervisor on site, involve BKI from framing, and sell no charter dates too early.
Short answers. Durations are industry-reported estimates; no official data exists.
Hull to launch: roughly 8–12 months at 20 m, 12–18 at 30 m, and 18 months to three years at 40 m-plus (estimate). Contract to sea trials, with fit-out and certification: about 14–30, 22–42 and 36–72 months.
A USD 130,000 hull quote excluded about USD 100,000 of fastenings. Local parties seized the hull; it was bought back at auction for around USD 40,000 after roughly USD 500,000 invested. A five-year Bali fit-out followed, ending near six times the USD 1 million assumption.
Timber sourcing and seasoning, monsoon weather, payment disputes over what the quote included, scope creep, fit-out venue changes and budget exhaustion. A 6–18-month overrun and a 20–50% cost overrun are commonly reported (estimates).
From the framing phase. Class surveys left to fit-out or completion can force rework of timber and systems already installed. Early involvement also tells the yard the build is being surveyed to a standard.
Add 30–50% to any quoted completion date as a planning baseline (estimate). Then allow a further six months after the projected sea-trial date before accepting any charter bookings.
No. A launched hull is a wooden shell — no engines, electrical systems, plumbing, interior, navigation equipment or safety certification. Fit-out alone can run from six months to three years (estimate).
