Skip to content
Build a Phinisi

Build a Phinisi:
Keel Ritual to Launch

Commissioning a wooden phinisi from the yards of South Sulawesi — brief, yard, contract, keel ritual, launch and the tow to fit-out. Written from the yard side, not the sales deck.

An Oral Craft,
A Written Contract

Phinisi are built at Tana Beru, Ara and Bira in Bulukumba, where the panrita lopi sets every dimension from memory — a craft UNESCO inscribed in 2017. The knowledge is oral, contracts are often trust-based, and quality control falls on whoever pays.

The Commissioning Process

Brief to fit-out, in the order it happens. Ranges are industry estimates, not promises: a 30 m charter-grade vessel started today should not be expected in service for 2.5–3 years.

01

Before the yard

Brief & Budget

Decide commercial or private, hull-only or turnkey, and length — with a naval architect. The hull quote is not the budget: Dunia Baru's hull was under 10% of the bill.

02

Site visits

Yard Selection

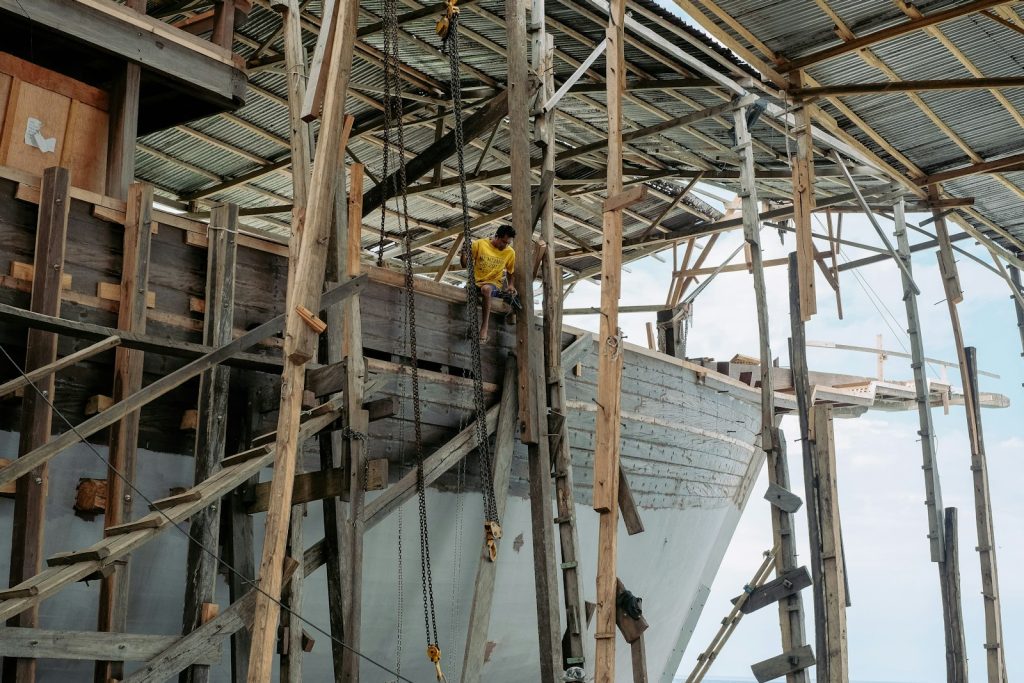

Visit a live build at Tana Beru, Ara or Bira. Check framing, fasteners and caulking, the builder's experience at your size, written milestones — and who represents you.

03

Before money moves

Contract & Payment

Milestones, commonly 20–30% at keel-laying (estimate), then frames, planking, deck and launch. Specify timber, scope, delay clauses and change orders; have a maritime lawyer review it.

04

Weeks to months

Timber Sourcing

Ulin ironwood comes by sea from Kalimantan — scarce and legally controlled. Green ulin moves after completion, so ask about seasoning and require proof of legal provenance.

05

Day one

Keel-Laying Ritual

Offerings and prayers open the vessel's life. For the panrita lopi the ceremony is inseparable from the craft — let him set the pace.

06

The long middle

Frames & Planking

Where unsupervised builds go wrong. Mixed metals, undersize bolts and too few keel-to-frame fasteners are common survey findings. Have a surveyor at frames-up and garboard planking.

07

Annyorong lopi

Launch

The community pushes the hull over greased rollers into the sea. Have your surveyor inspect below the waterline before it is fully afloat — fixes are cheaper here.

08

Plus 6–18 months

Tow & Fit-Out

The engineless hull is towed to Benoa, Surabaya or Jakarta — roughly 1,400–1,500 nautical miles to Bali. Engines, systems, interior and certification follow.

Hull-Only or Turnkey

A Sulawesi yard can deliver a launched, unpainted, unengined hull. Everything after that is a second project — usually in Bali, Surabaya or Jakarta. Budget for it before you sign in Bulukumba.

Hull-Only Contract
01

Hull-Only Contract

  • Keel, frames, planking, deck beams and basic superstructure framing — launched, unpainted, unengined.
  • Fastenings, chain plates and deck hardware are often extras: get a line-item scope.
  • Dunia Baru: USD 130k hull, plus ~USD 100k of bolts outside the quote (verified).
Turnkey Build
02

Turnkey Build

  • Engines, electrical, navigation, plumbing, interior, safety equipment and rig — through to a certificated vessel.
  • Systems, interior and fit-out often cost two to five times the hull price.
  • USD 120–400k at 20–30 m up to USD 1–2M at 35–40 m (estimate).

How the Yards Work

The craft is genuine and the builders are extraordinary. Your commercial specification — class, insurance, systems — exceeds what a traditional yard builds for its traditional customers.

01

The Panrita Lopi

The master builder is chief designer, project manager and ritual specialist. Keel curve, stems and frame spacing live in his memory, passed down within families. There are no drawings.

02

Ulin, Bitti and Jati

Ulin ironwood for keel, frames and garboards resists teredo worm. Sulawesi-native bitti bends for curved planking and frames. Teak (jati) goes into decks and interior structure.

03

Three Layers of Oversight

An independent build surveyor at milestones, a naval architect before the build for lines and scantlings, and BKI during construction — not retrospectively, once compartments are closed.

Questions Commissioners Ask

Short answers. Costs and timelines are industry estimates unless marked; none of this is legal or financial advice.

How long does it take to build a phinisi from keel-laying to launch?

Hull construction typically runs 8–12 months at 20 m, 12–18 months at 30 m and 18–24+ months above 40 m (industry estimates). Contract to commercial operation, including fit-out, is typically two to four years. Dunia Baru took eight (verified).

Can foreigners supervise a phinisi build in Bira or Tana Beru?

Yes. Nothing prohibits visiting the yards, hiring an independent surveyor or a site project manager. The challenge is presence: use a qualified local representative on site weekly, backed by milestone visits from a credentialled build surveyor.

What is the difference between a hull-only contract and a turnkey build?

Hull-only is the launched, unpainted wooden shell without engines, systems or interior. Turnkey runs through to a seaworthy, certificated vessel. Systems, interior and fit-out often cost two to five times the hull price.

What is the annyorong lopi ceremony?

The Konjo-language name for the communal launch: the community pushes the finished hull from the beach into the sea with prayers and offerings. It is also your best chance to inspect the hull below the waterline.

Do I need a naval architect for a new build?

Not legally for a private vessel below 24 m, though it is prudent. For commercial charter it is effectively necessary: BKI class needs the stability calculation and scantling specification a naval architect produces.

What does independent supervision cost?

A build surveyor for four to six milestone visits over an 18-month hull build might cost USD 8–20k; a naval architect from brief to launch, USD 15–40k for a mid-size vessel (estimates). One structural remediation costs more.
